Search
Close this search box

Dogger Bank B Passes Halfway Mark as Seaway Ventus Prepares to Join Voltaire

Dogger Bank B has passed the halfway point in turbine installation, with 49 of 95 turbines installed. Seaway7's Seaway Ventus is preparing to join Jan De Nul's Voltaire at the UK offshore wind project.

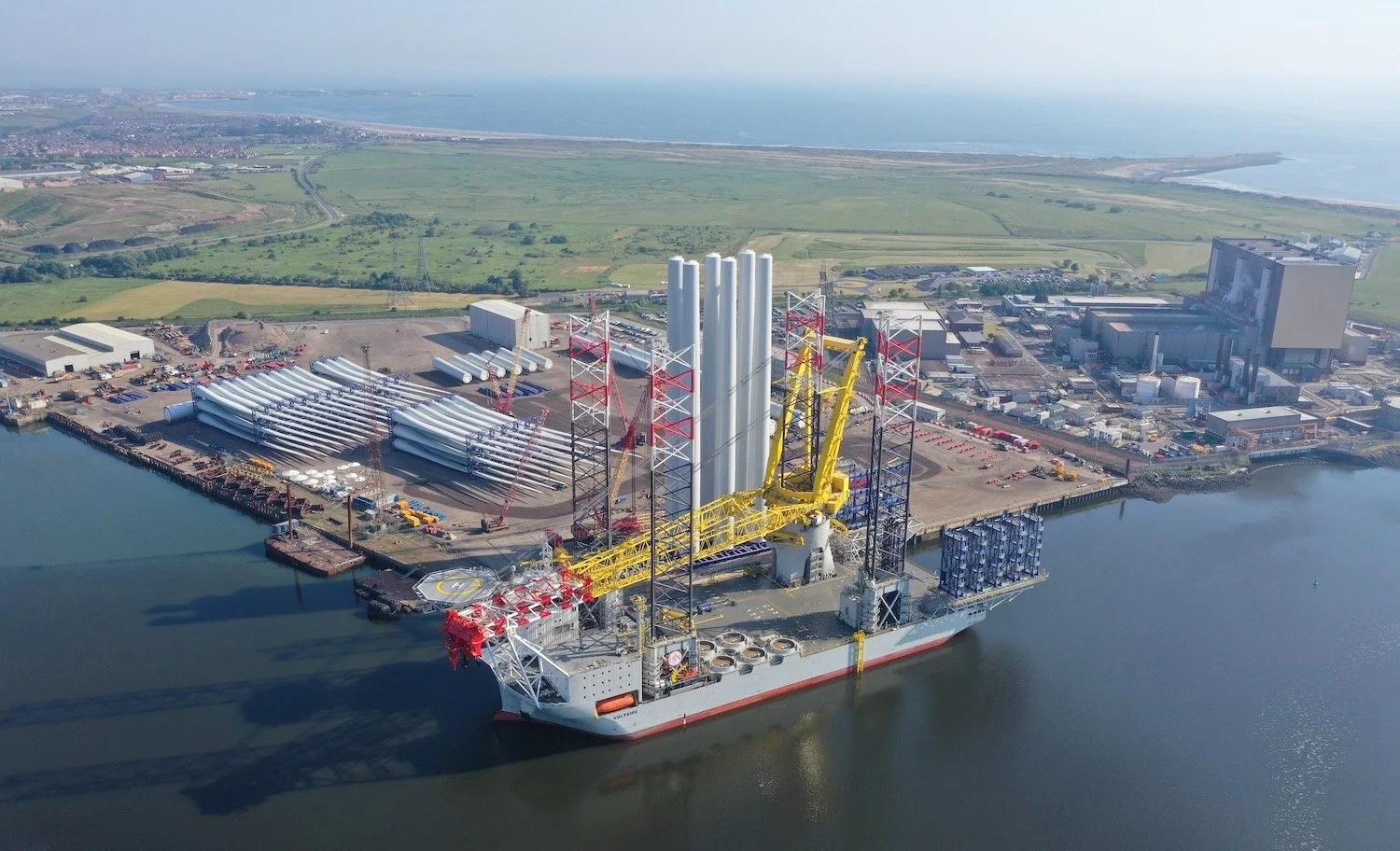

Jan De Nul’s Voltaire at Able Seaton Port, UK. Photo: Courtesy of Able UK.

SHARE ARTICLE

The Dogger Bank B offshore wind project in the UK has passed the halfway point in turbine installation, with 49 of its planned 95 GE Vernova Haliade-X 13 MW turbines now installed.

The milestone was reported in the latest maritime operations notice issued by the Dogger Bank Wind Farm project team, covering construction activities in early October 2026.

Jan De Nul’s wind turbine installation vessel (WTIV) Voltaire has been working at Dogger Bank B since installing the phase’s first turbine in March 2026. The vessel previously completed turbine installation at Dogger Bank A, the first phase of the development, in February.

The installation campaign is preparing to expand with the addition of Seaway7’s jack-up installation vessel Seaway Ventus. The vessel was scheduled to arrive at Dogger Bank B on 9 October, according to the project’s latest maritime notice as reported on 8 October.

Seaway7 secured the work under a vessel reservation agreement announced by SSE Renewables in December 2024. The agreement covers additional turbine transport and installation capacity for the Dogger Bank development.

The latest milestone follows an earlier project update in June, when Dogger Bank B reached 20 installed turbines.

Turbine component logistics for Dogger Bank B and C are being supported through Maraen Port of Nigg in Scotland. GE Vernova selected the facility as a marshalling port after previously using Able Seaton Port in Hartlepool for Dogger Bank A and the initial installation activities at Dogger Bank B.

The 1.2 GW Dogger Bank B development forms the second phase of the 3.6 GW Dogger Bank Wind Farm, jointly owned by SSE Renewables, Equinor and Vårgrønn.

The overall project comprises three phases with 277 planned turbines. Dogger Bank A and B will each have 95 Haliade-X 13 MW turbines, while Dogger Bank C will feature 87 Haliade-X 14 MW units.

Turbine installation at Dogger Bank B is expected to continue until approximately the second quarter of 2027, with installation work at Dogger Bank C scheduled to begin in 2027.

Editorial Note:
This article was prepared with the assistance of AI tools to enhance clarity and efficiency.
All information has been reviewed and verified by the HMT News editor.
Wind Apex is scheduled to begin work at Dogger Bank C in Q3 2027, while Cadeler has two further T-class installation vessels on order for delivery in 2030 and 2031.
Windcat's second MP-ASV is due for delivery in the first quarter of 2029, with a capacity of 190 persons on board, a 150-tonne subsea crane and provision for up to 150 days offshore.
With an estimated construction cost of KRW700 billion, the proposed public-sector vessel would handle 15–20MW turbines, while private companies pursue the introduction of around four large WTIVs.

Subscribe to HMT WEEKLY

Receive HMT WEEKLY in your mailbox.

Heavy Marine Transport News, Delivered Daily — Stay informed on shipping, offshore, and global logistics.

SECTION

INFORMATION

CONTACT

For general inquiries and to contact us,
please email: info@hmt-news.com
